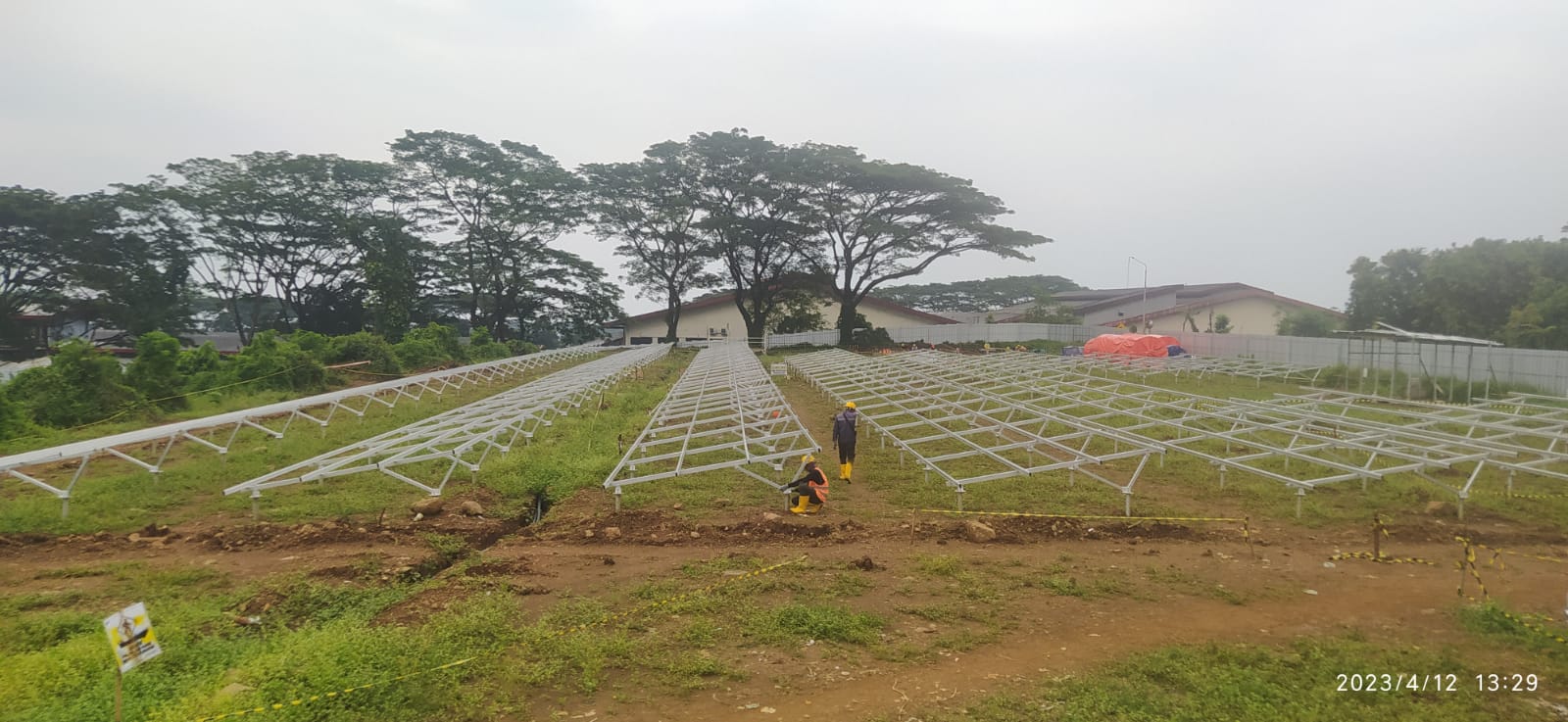

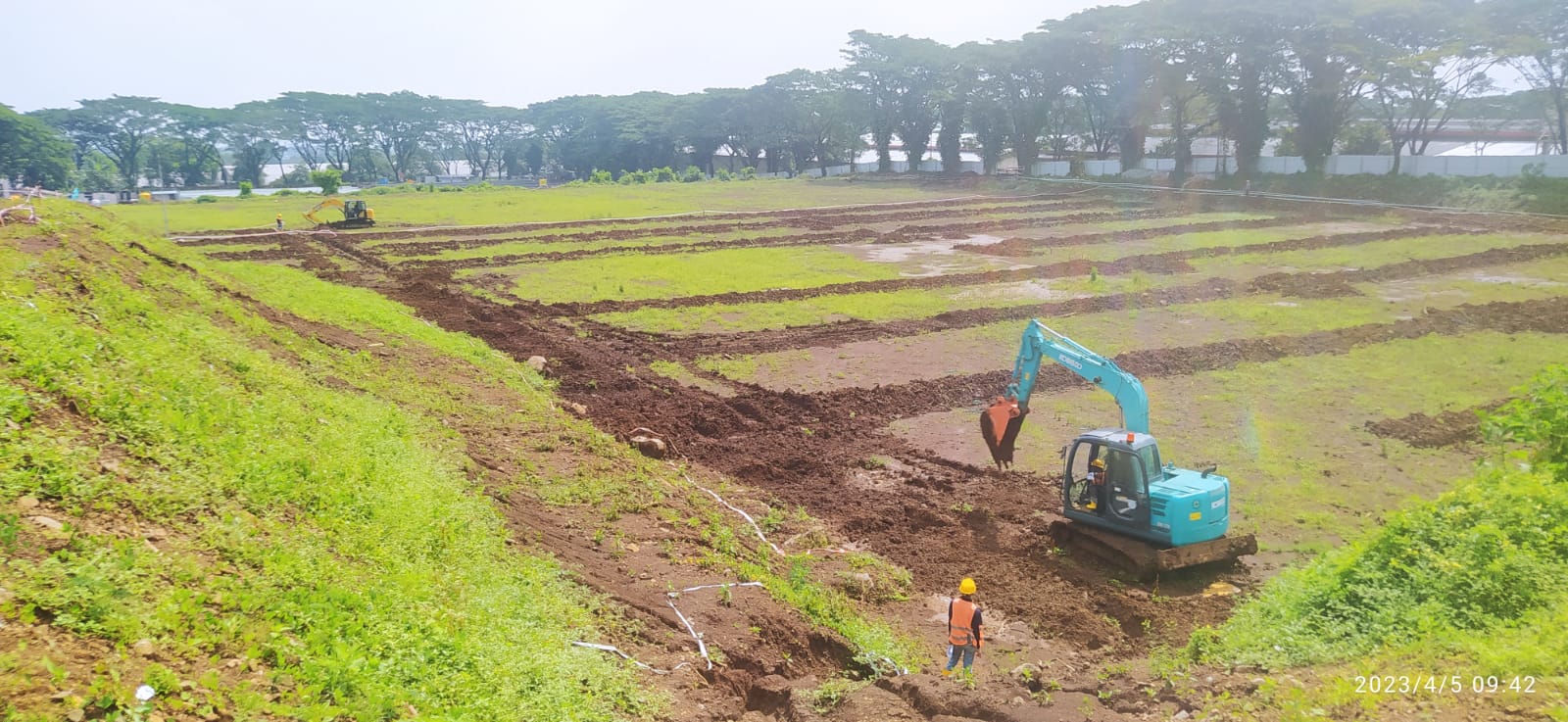

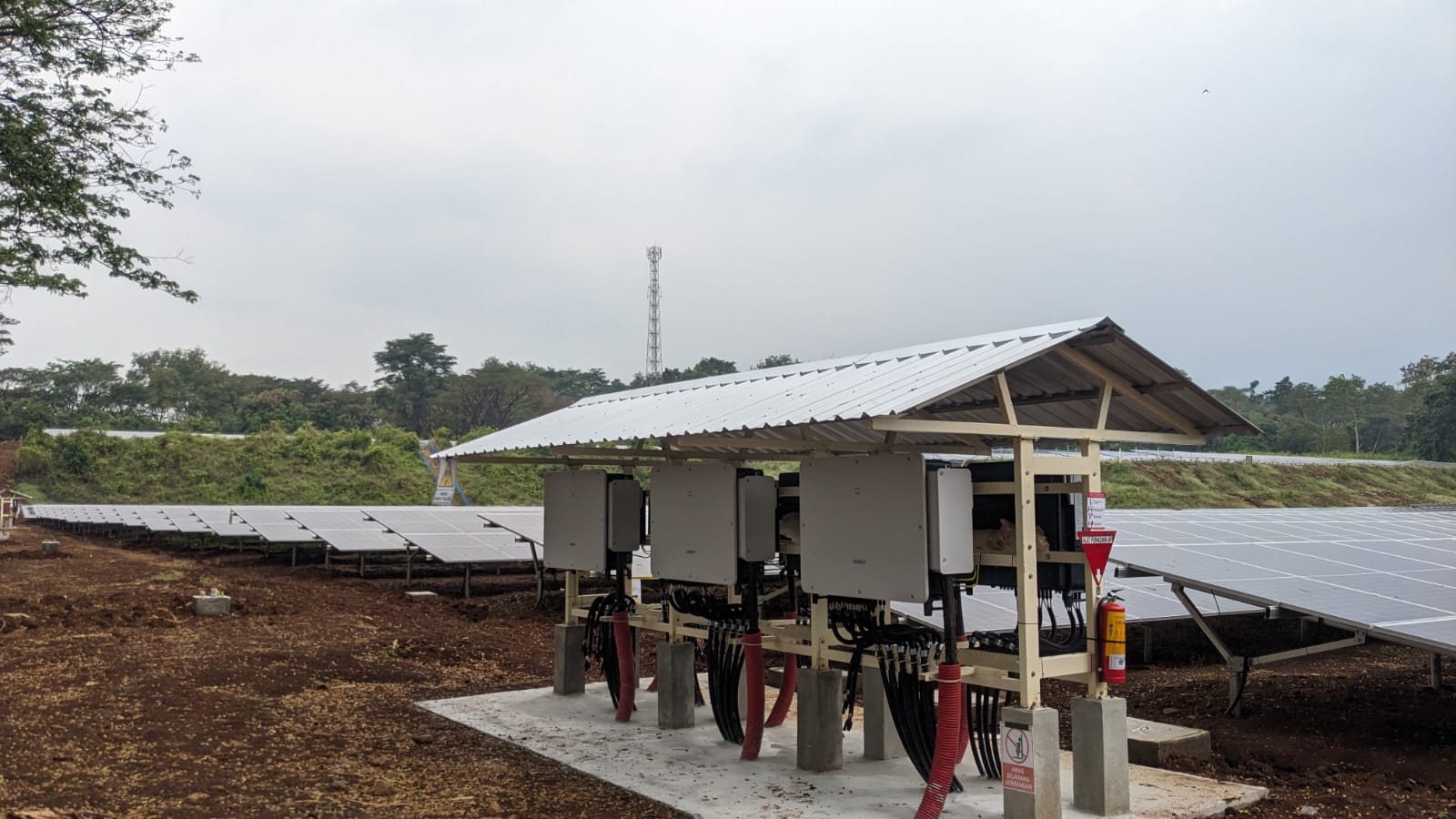

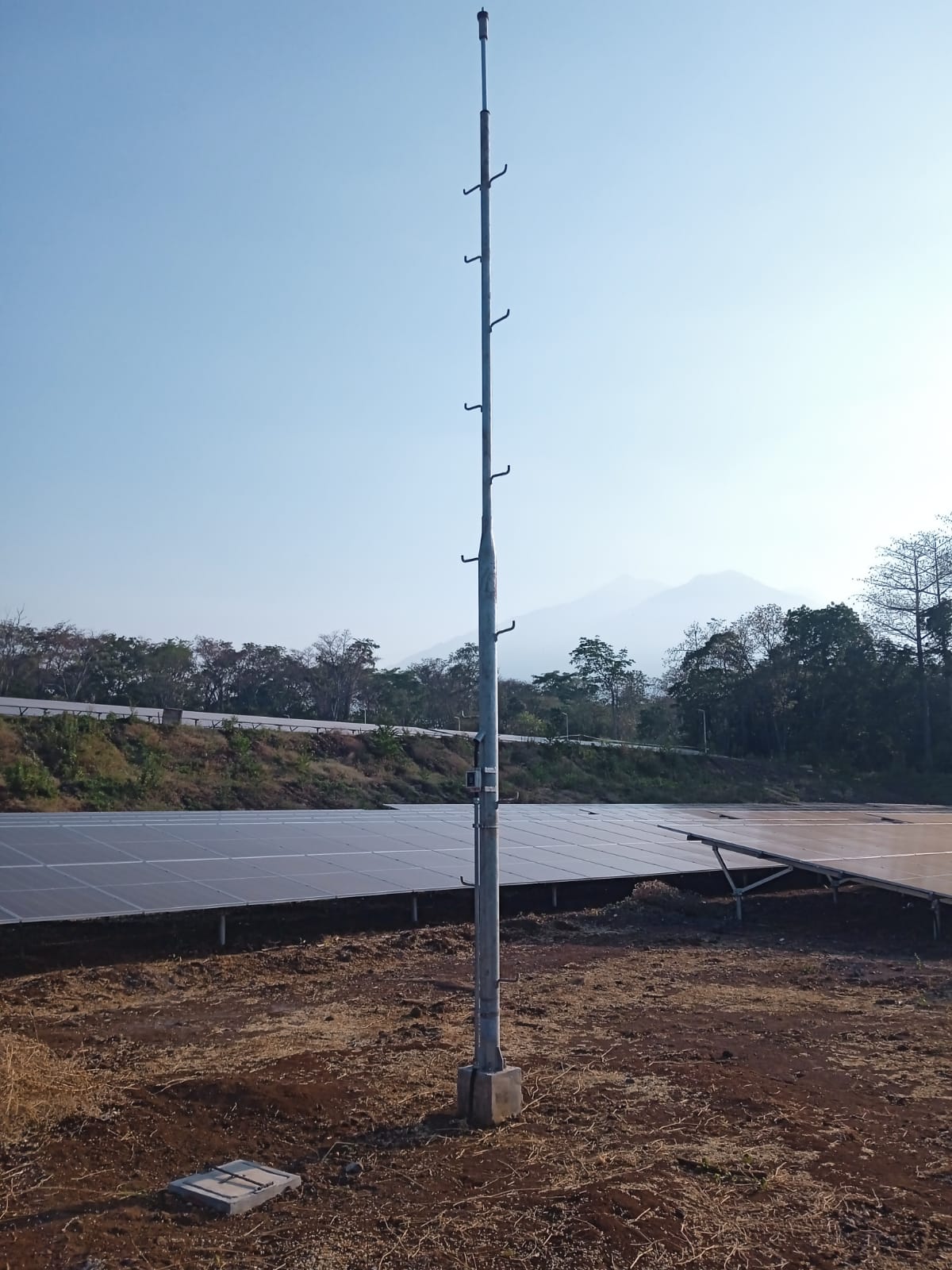

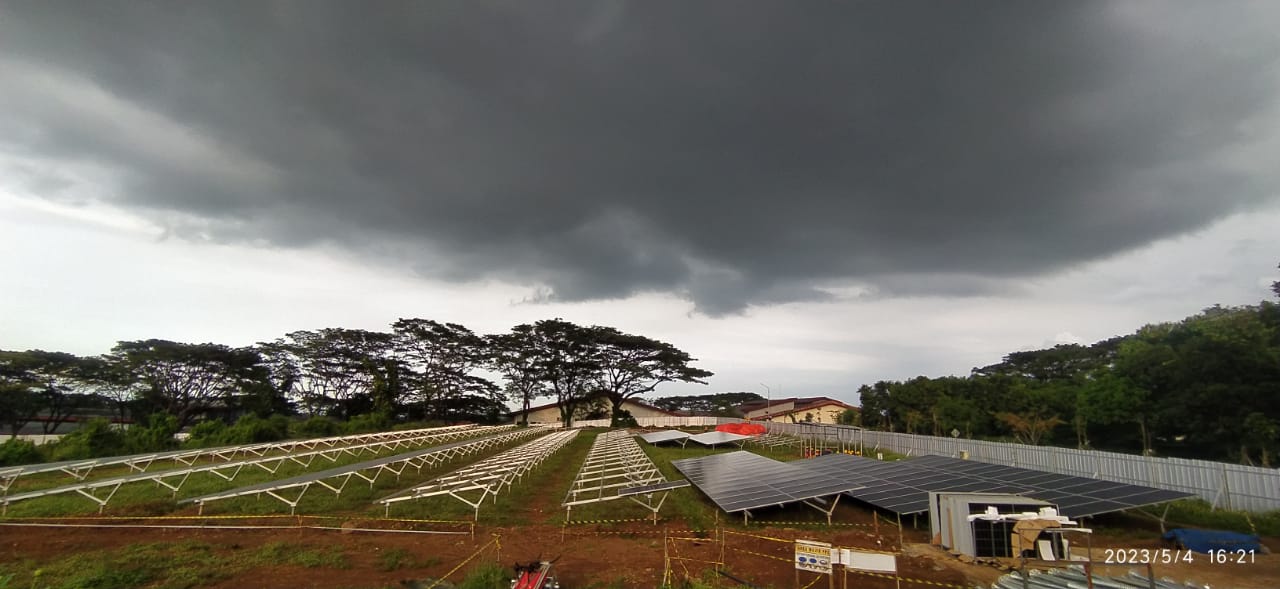

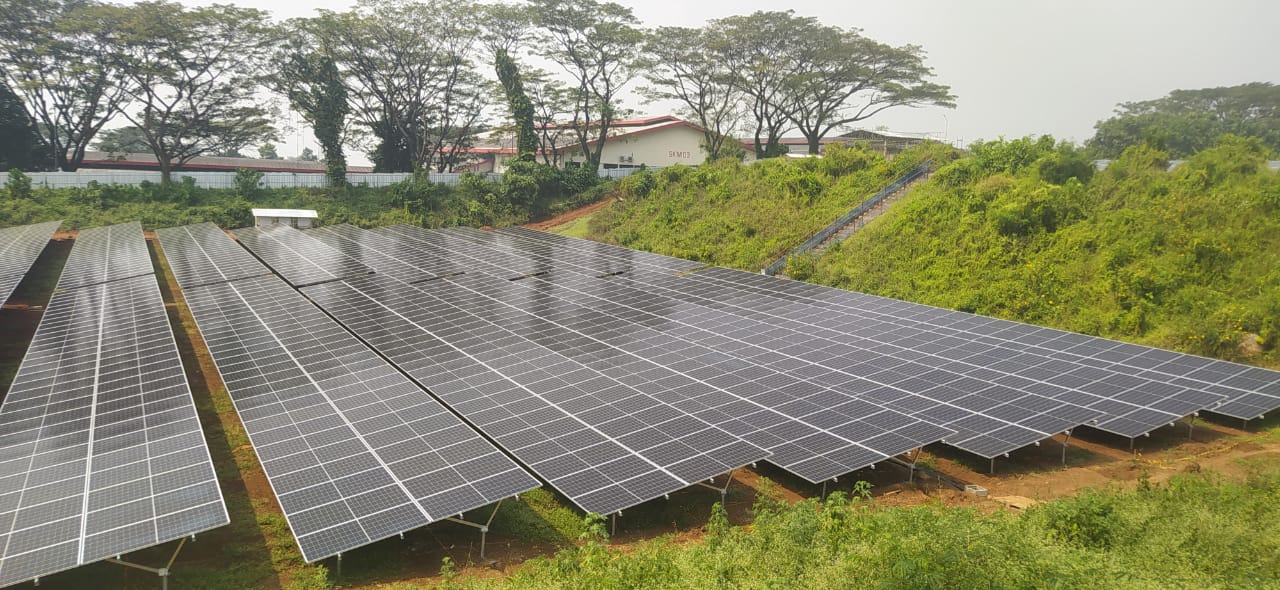

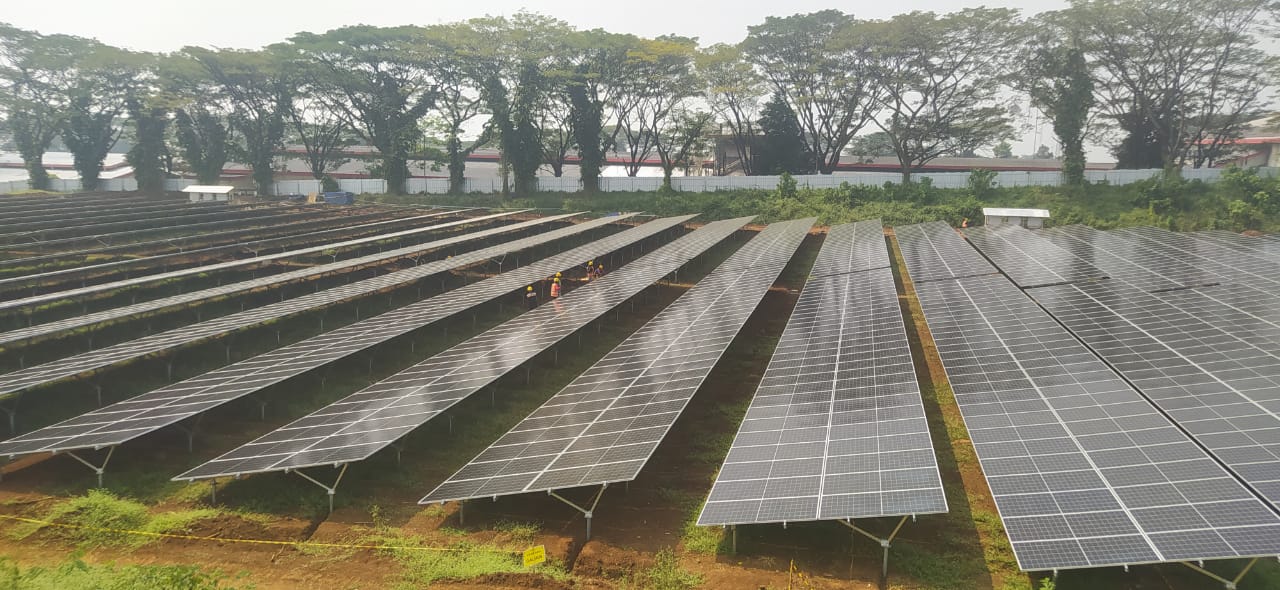

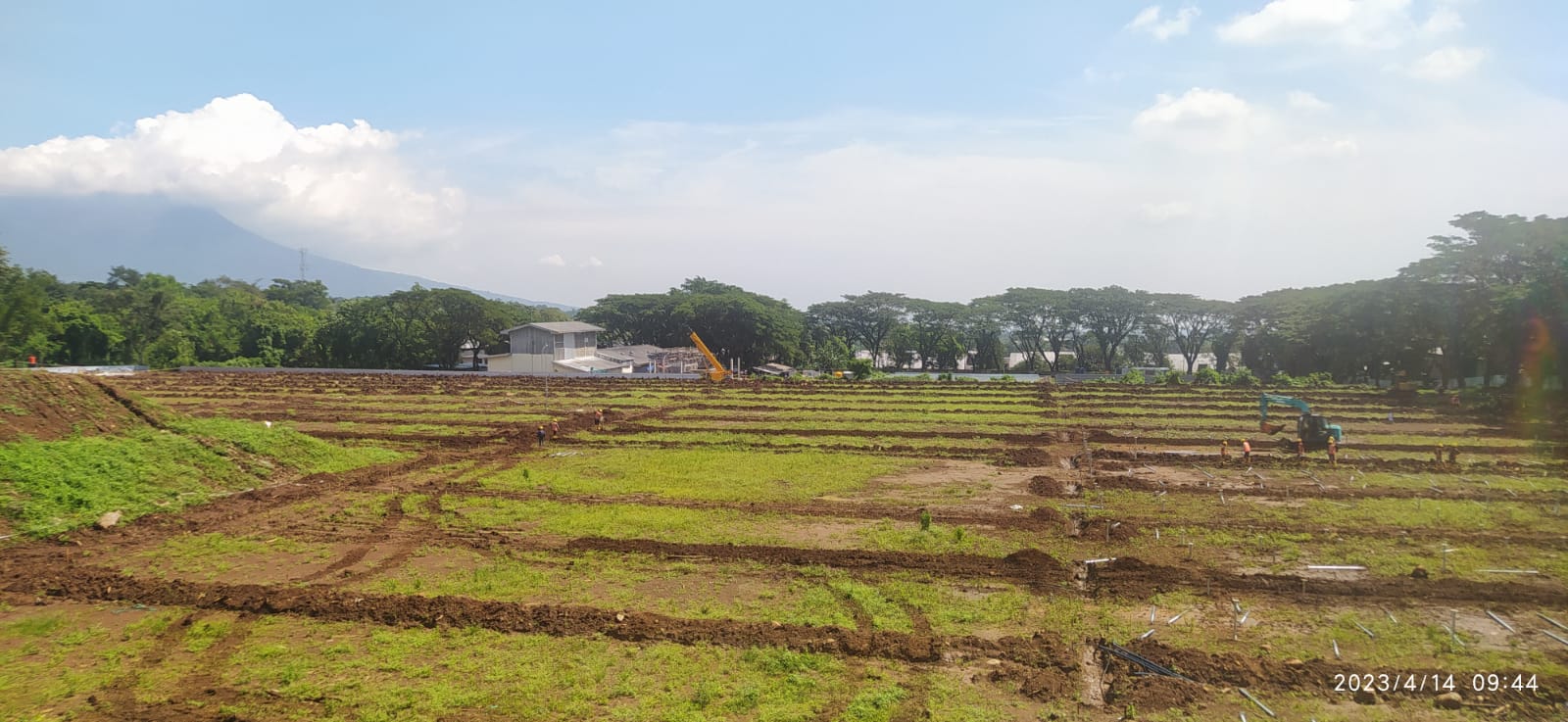

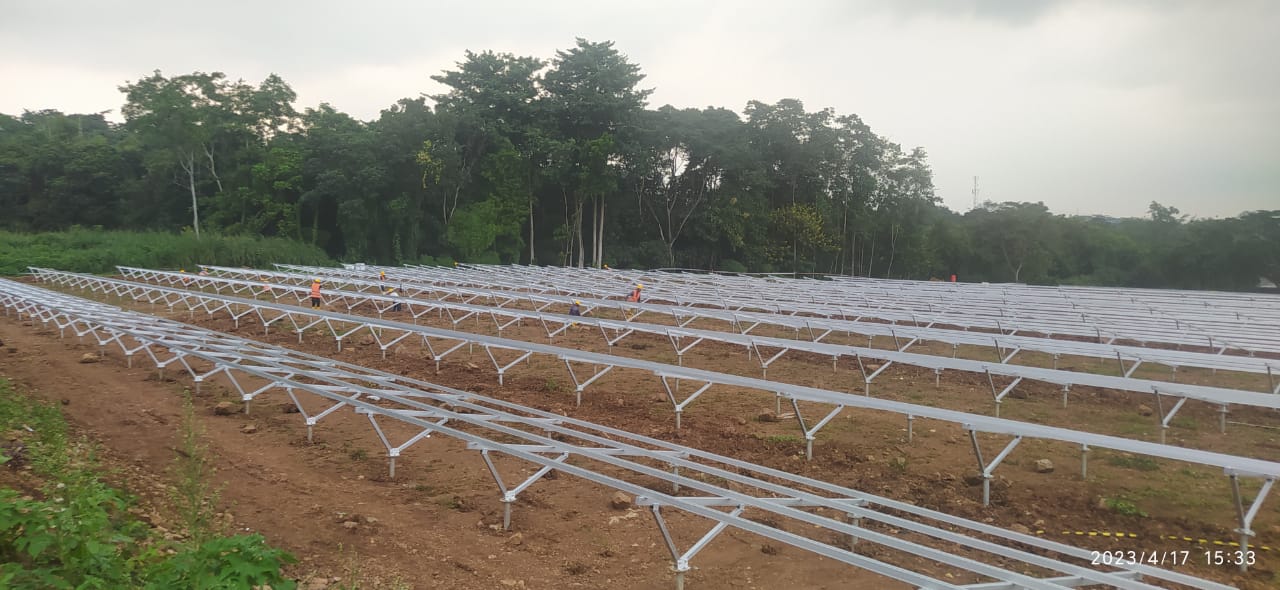

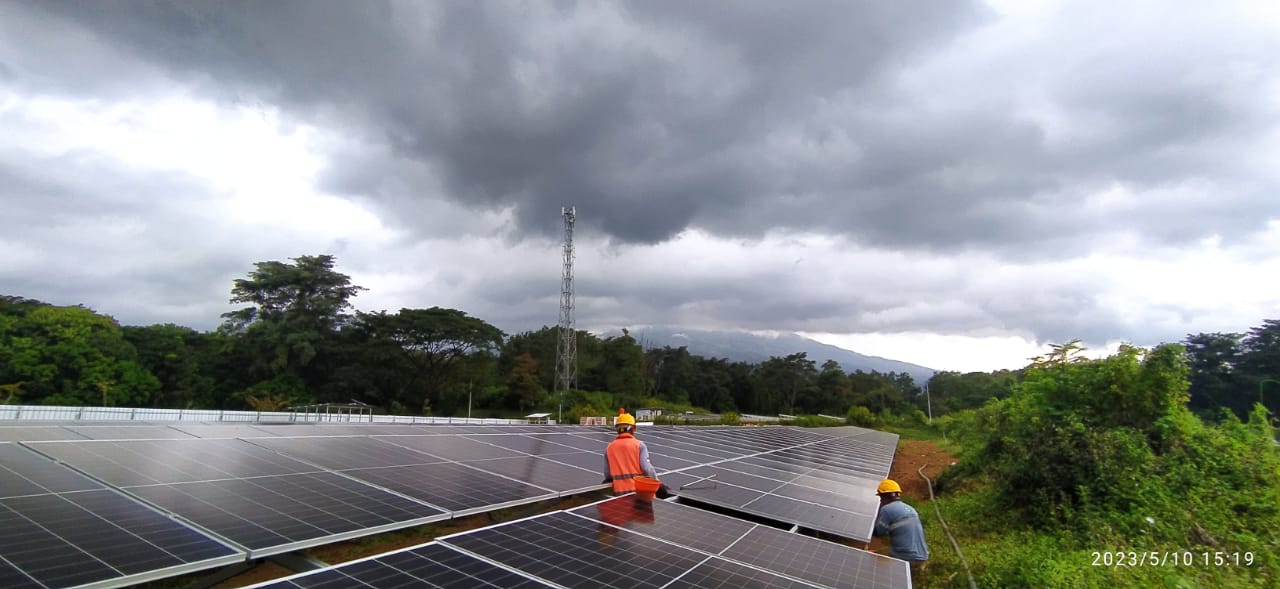

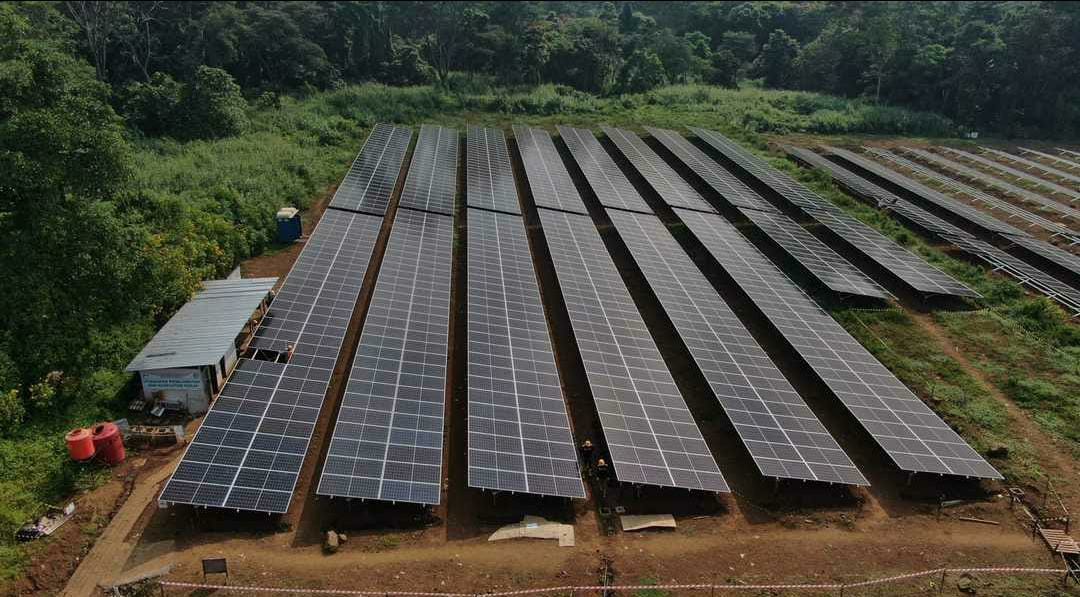

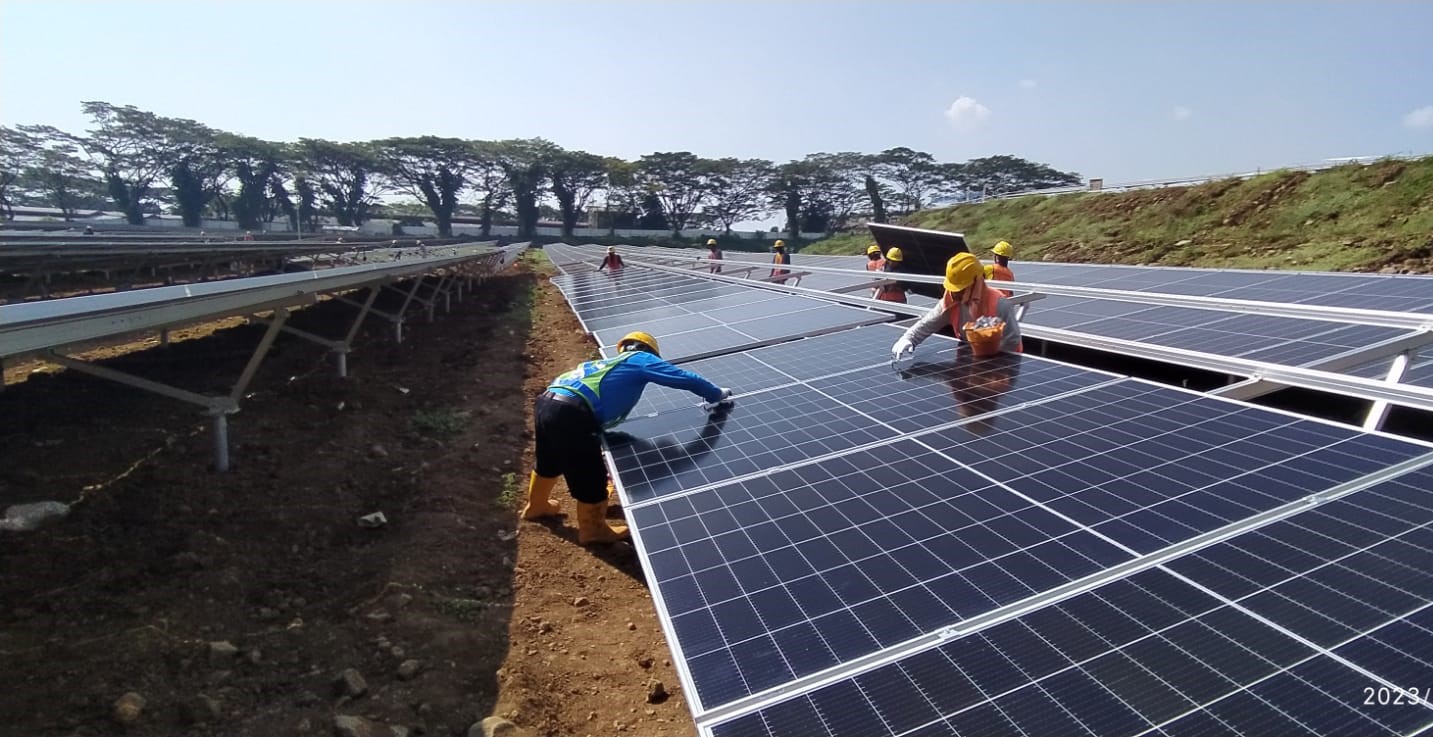

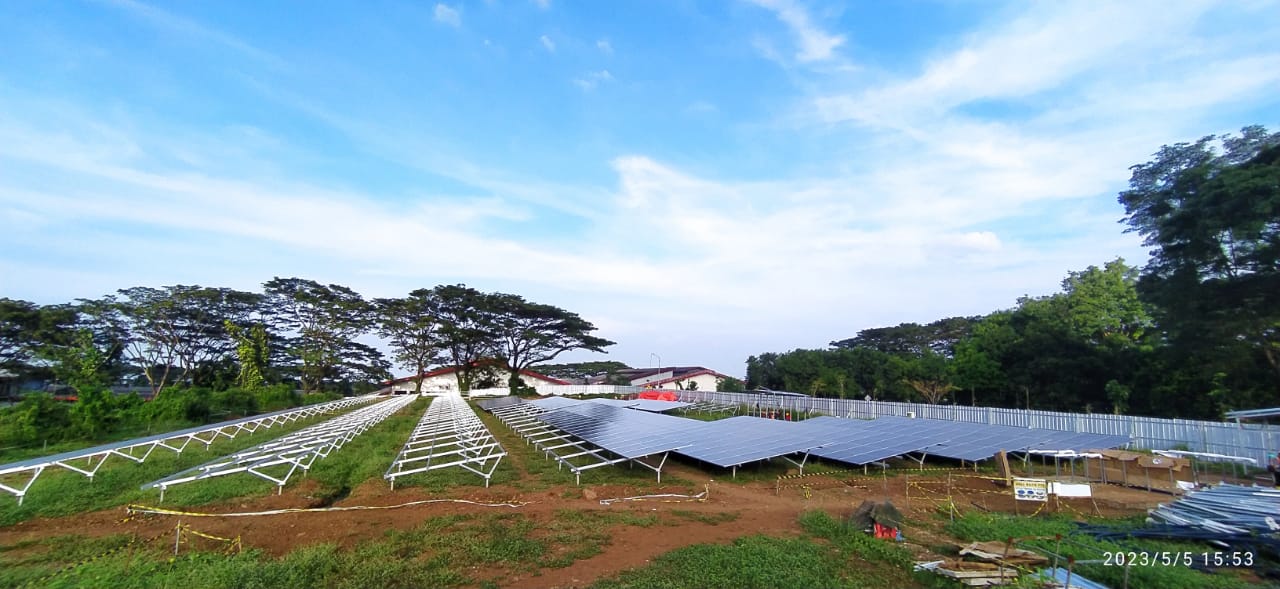

TIS delivered 3.6 MWp out of 7 MWp available capacity. this project gives some challenges such as ground elevation, underground cable laying system, medium level of rocks to extreme weather in between Feb-Apr. A total peak of 62 manpower working in a team to finish the project on time.
